How to Scope a Design Project. Parallel partners with US AI-native and B2B SaaS teams.
Every blown design budget I've seen at Parallel HQ traces back to the same root cause: the scope conversation happened too late, too loosely, or not at all. Knowing how to scope a design project is not an admin formality, it's the foundational act of product design leadership. Get it right and you ship faster, spend less, and keep your team intact. Get it wrong and you're six weeks in, three pivots deep, with a Figma file that belongs to nobody.
Most founders treat scoping as "writing down what we want." It's not. Scoping is the process of defining the goals, scope, and boundaries of your project, as well as the resources, roles, and responsibilities involved. For a UI/UX engagement, that means translating a product vision into a structured agreement that every stakeholder can point to when the conversation drifts. Project scope defines the boundaries of your project, including the goals, deadlines, and deliverables your team will work toward, and what falls outside those boundaries. That second half, what falls outside, is where most early-stage teams fail. They scope what they want but never document what they're not doing.

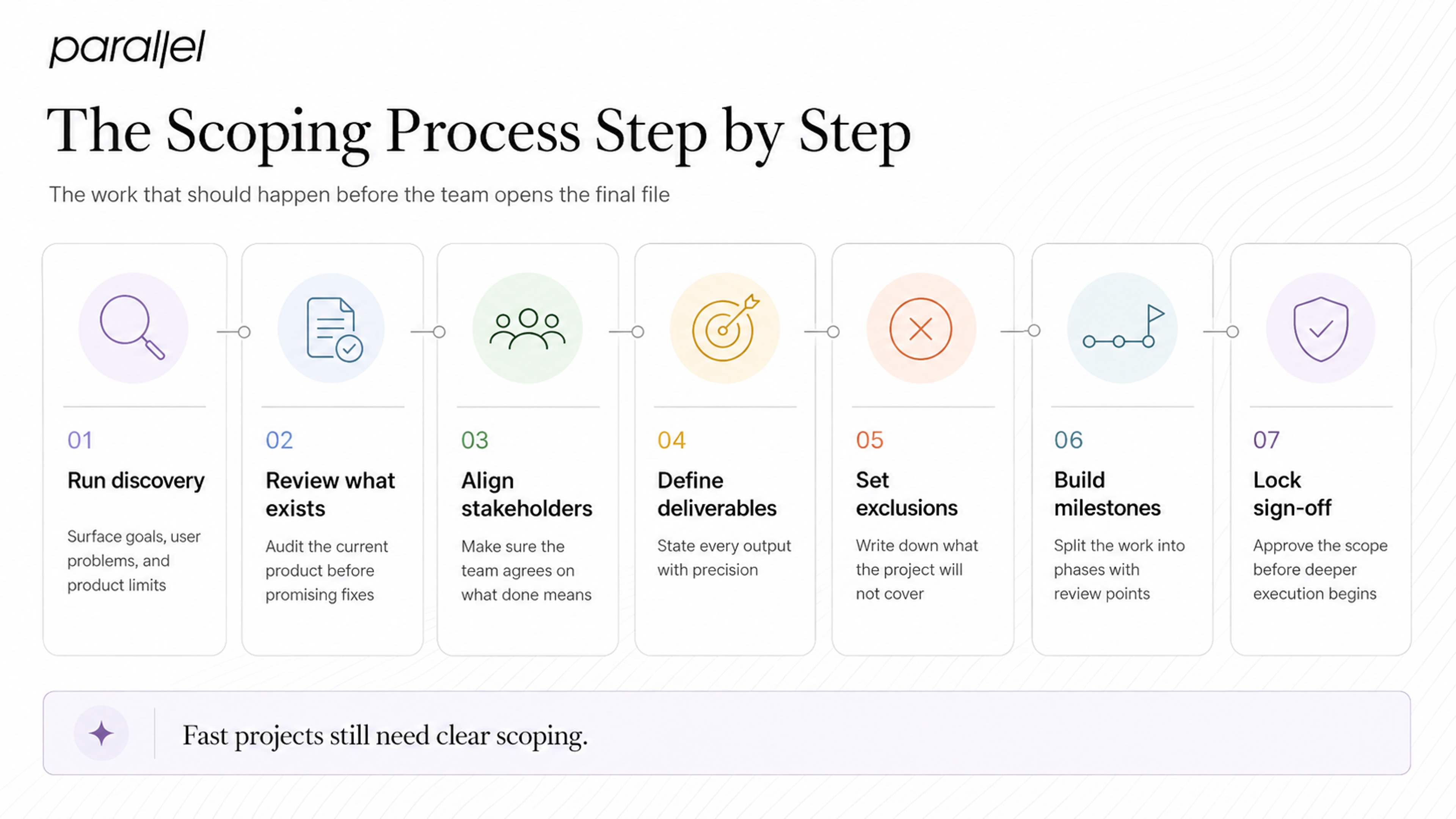

At Parallel HQ, I use four layers to define scope on every engagement:
The five core components of any scope statement are: project goals and objectives, deliverables, scope boundaries and exclusions, constraints like budget or timeline, and acceptance criteria. In a design context, acceptance criteria often gets skipped, which is exactly why clients and agencies end up in a room arguing about whether the work is "done."
A useful mental model: the scope document is a shared reality, not a sales tool. It doesn't exist to impress the client. It exists so that the designer working in Figma at 11pm knows whether a new component they're building is in scope or a favor.
Being a great designer isn't enough to keep your projects on track and on budget, it's vital that early in the project, you define the scope. This is useful because clients will know when you have delivered what you said you would, you will know when you have finished a project, and it prevents scope creep.
This is the exact flow I run at Parallel HQ before a single pixel gets designed.

A scope document for a UI/UX engagement is not a creative brief. It's closer to a project charter with design-specific anatomy. Here's the full list of what must appear:
| Section | What It Contains |
|---|---|
| Project Overview | Business context, product goal, target user |
| Design Brief Summary | Key problems to solve, design principles, brand constraints |
| Deliverables Matrix | Every output, format, quantity, and owner |
| Out-of-Scope Items | Explicit exclusions, copy, dev handoff, motion design |
| Project Timeline | Phase-by-phase milestones with dates |
| Budget and Payment Schedule | Total fee, tied to milestone approvals |
| Revision Policy | Number of revision rounds per deliverable |
| Change Order Process | How new requests are evaluated and priced |
| Acceptance Criteria | What "approved" means for each deliverable |
| Stakeholder Roles | Who reviews, who approves, who is informed |
The project scope statement is a detailed outline that includes a timeline, budget, assigned tasks, project stakeholders, and workflow strategies. With a well-defined project plan and scope statement, project managers can easily oversee each step in the project's delivery, keeping contributors on task, within budget, and on track to meet deadlines.
The deliverables matrix is the most underused piece. When a startup asks for "a full product redesign," I break that into a table with every screen, flow, and component, so there's no ambiguity about what's in the package. This single artifact prevents the majority of scope disputes I've seen in agency work.
The discovery conversation is where scope lives or dies. These are the questions I ask on every intake call, grouped by purpose.

Business context:
User and product reality:
Scope and constraints:
Preferences and aesthetic direction:
Content and dependencies:
Every answer either confirms what's in scope or reveals something that needs to be added, removed, or flagged as a risk.
The Statement of Work (SOW) is the legal and operational backbone of your engagement. Here's how to write one that holds up.

Structure the SOW in this order:
For a SaaS product design engagement, I also add a design system clause: who owns the component library post-handoff, and whether Parallel HQ retains the right to use screens in our portfolio. Small things. Huge headache if left unaddressed.
Keep the language plain. An SOW written in legal boilerplate gets ignored. One written in plain English gets read, understood, and referenced.
Estimation is where most agencies either pad wildly or under-quote to win the deal. Neither serves the client. Here's the framework I use.
Start with phase-level estimation, not task-level:
| Phase | Typical Duration (Startup MVP) | Driver |
|---|---|---|
| Discovery & UX Audit | 1–2 weeks | Complexity of existing product |
| Information Architecture | 1 week | Number of user flows |
| Wireframing | 2–3 weeks | Screen count |
| Visual Design (Figma) | 3–4 weeks | Design system maturity |
| Prototyping & Handoff | 1 week | Dev team readiness |
Three variables drive every estimate:
For budget, I work backward from a fixed budget or forward from a scoped deliverables list, never both simultaneously without reconciling them explicitly. If the budget can't cover the deliverables, the deliverables get cut, not the quality. Never estimate on optimism. Estimate the last comparable project you completed, then add 20% for stakeholder-driven changes you can't predict.
A well-run design sprint can compress the discovery and wireframing phases into 3–5 days, making it a high-value option when a startup needs scope clarity before committing to a full engagement.
This is the most expensive mistake early-stage product teams make, and the data is stark. Approximately 52% of projects across industries experience scope creep, with this figure soaring to over 80% in less structured environments like freelancing and small agency work. 85% of projects that encounter scope creep exceed their initial budgets, with an average cost overrun of 27%.
In 2025, projects without formal change management are 35% more likely to experience cost overruns and missed deadlines. The causes are predictable. Poorly defined project requirements emerge as the number one cause of scope creep. When project objectives, deliverables, and boundaries aren't clearly documented at the project's outset, stakeholders naturally fill in the gaps with their own interpretations.

Here's how I prevent it:
Scope creep is not a client problem. It's a process problem. The best clients I've worked with pushed hard for additions, because that's what good founders do. The job of a scoping process is to channel that energy through a change order rather than letting it quietly inflate the project.
Knowing how to scope a design project is the difference between a team that ships and a team that spirals. Here are the four things I want you to take away:
If you want to start your next engagement on solid ground, Parallel HQ's discovery framework is built exactly for this.
A creative brief captures the aesthetic direction, brand voice, and communication goals, it's an input to the design process. A Statement of Work is a contractual document defining deliverables, timelines, revision limits, and fees. You need both, and they serve different purposes.
For a straightforward startup engagement, scoping takes 3–5 business days: one discovery session, one internal estimation pass, one SOW draft, and a review round with the client. More complex enterprise or multi-platform products can take 1–2 weeks.
If you can't list every deliverable in one page, it's probably too broad. If you haven't addressed the primary user flow or core problem, it's too narrow. The right scope fits the budget, resolves the core problem, and produces something shippable.
Not always, but if there's no existing research, not scoping it in is a risk. Designing without user research means the team is designing for assumptions. For AI and SaaS products especially, a user research phase almost always surfaces requirements that change the scope anyway.
It triggers a change order, a brief written document that states the new request, the estimated additional effort, the timeline impact, and the cost. Work on the new request begins only after written approval. This protects both the agency and the client.
Yes, and it works well when combined with a fixed-scope discovery phase. Define the overall boundaries and deliverables upfront, then execute in sprints. Agile doesn't mean scope-free, it means the scope is revisited at sprint boundaries through a formal prioritization process, not ad hoc mid-sprint.
